Phase 2

Sanitary Sewer Expansion - Westport Neighborhood

Please contact Public Works with any questions at publicworks@oshtemo.org or 269-216-5244.

Community Meeting Presentation(PDF, 3MB)





News/Updates

10/16/2026

All 2026 paving work is complete. Restoration and maintenance of restored areas will continue through October.

If you have questions/comments/concerns about completed work, please contact Public Works at 269-216-5244 or publicworks@oshtemo.org

Ramblewood, Ashwood, Karabrooke, Countrywood, Winddrift, and Maple Leaf - Cleaning and televising of the new sanitary sewer is ongoing. These segments are expected to be ready for connections in early November.

Bramble Dr, Rose Arbour (Cul-de-sac) - Manhole adjustments are ongoing. Concrete crews will be returning on 10/22 to pour the concrete around the manhole structures. Cleaning and televising of the new sanitary sewer is scheduled for 10/19 - 10/22. These segments are expected to be ready for connections in early November.

Rose Arbour (Bramble to 9th St), Chesapeake, and Redbud Trail - Manhole adjustments are ongoing. Concrete crews will be returning on 10/22 to pour the concrete around the manhole structures. Cleaning and televising of these segments is scheduled for 10/26. Lift station work will continue into November. These segments will not be ready for connections until the lift station is operational in Spring 2027.

Saybrook - Lift station construction will continue through November.

10/9/2026

While mainline sanitary sewer installation is complete for this year, the project area remains an active construction zone. Please use caution and remain alert when traveling through these areas.

Ramblewood, Ashwood, Karabrooke, Countrywood, Winddrift, and Maple Leaf - Manhole adjustments are still in progress. Cleaning and televising of the new sanitary sewer will take place the week of 10/12. Restoration efforts are ongoing.

Bramble Dr, Rose Arbour (Cul-de-sac) - Manhole adjustments are underway. Cleaning and televising of the new sanitary sewer is expected to begin the week of 10/19. Restoration will continue through the week of 10/12.

Rose Arbour (Bramble to 9th St), Chesapeake, and Redbud Trail - Top course of asphalt is scheduled for 10/12. Manhole adjustments and cleaning and televising will begin the week of 10/26. Restoration will begin the week of 10/12.

Public Works is actively monitoring restoration progress for quality throughout the project.

If you have questions/comments/concerns about completed work, please contact Public Works at 269-216-5244 or publicworks@oshtemo.org

10/1/2026

Mainline sanitary sewer installation is now complete for 2026.

Ramblewood, Ashwood, Karabrooke, Countrywood, Winddrift, and Maple Leaf - Manhole casting installation and restoration work is still ongoing. Cleaning and televising of the new sanitary sewer is scheduled for the week of 10/5. Asphalt driveway top course paving is scheduled for 10/7.

Bramble Dr, Rose Arbour Cul-De-Sac - Top course of asphalt paving for these segments has been moved up to 10/2. Please expect delays during this work. Manhole casting installations and additional concrete work is expected for the week of 10/5.

Rose Arbour (Bramble to 9th St), Chesapeake, and Redbud Trail - Concrete work will continue on these segments on 10/2 and into the week of 10/5. Base paving for these segments has been moved to Wednesday, 10/7.

Saybrook Dr - Lift station construction is underway. There are no closures expected for this road while work occurs.

Peters Construction has begun a fire hydrant addition project that overlaps with the phase 2 project area. This work will improve the water system and provide additional hydrants for emergency response. There are no planned water service outages related to this project. It is expected to be completed by November 1st.

9/25/2026

Ramblewood, Ashwood, Karabrooke, Countrywood, Winddrift, and Maple Leaf -  Road paving is complete! Asphalt driveway top course paving for these areas will be coordinated with the paving activities on other segments of the project. Restoration is ongoing in these areas and residents may begin scheduling sprinkler system repairs. Please see the restoration guide in the FAQ for more details on this process. Manhole casting structures and concrete work in the roadway will continue in these areas through next week. As a reminder, please use caution when driving through these areas as work is still active.

Bramble Dr, Rose Arbour Cul-De-Sac - The force main installation for the Rose Arbour lift station is underway. Restoration activities will continue through next week. Top course of asphalt will be coordinated with the remaining portion of Rose Arbour to 9th St and Chesapeake and Redbud Trail.

Rose Arbour (Bramble to 9th St), Chesapeake - Concrete curb and gutter and driveway repairs began 9/25. Please allow at least 3 days before driving over the new surface. Refer to the construction FAQ for more details. Base paving for this segment is planned for Monday 10/5.

Redbud Trail - Mainline installation is expected to be completed today. Redline will continue working on installing the laterals for each property and rebuilding the road. Access will be partially restored by end of day today and it is anticipated to be fully open by 9/30. This road will be base paved on 10/5 with Rose Arbour and Chesapeake.

The top course of asphalt for Bramble, Rose Arbour, Chesapeake, and Redbud Trail will be completed no later than 10/15.

9/18/2026

Ramblewood - Final paving is scheduled for 9/21, weather permitting. Please plan for 30 - 45 minute delays during this work.

Rose Arbour (Redbud Trail to 9th St) - Mainline installation is tentatively scheduled for completion today. Road restoration is expected to be completed by end of day on 9/21. Concrete repairs for this segment are tentatively scheduled for 9/25.

Redbud Trail - Mainline installation is scheduled to begin on 9/22. Residents will need to park on the north side of Rose Arbour the evening of 9/21.

Residents with curb and gutter that have a green flag in their yards may begin scheduling and completing sprinkler system repairs.

9/11/2026

Rose Arbour (Redbud Trail to 9th St) - Mainline installation will continue through the week of 9/14. Residents at 6593, 6594, 6615, 6616 Rose Arbour will need to park on the north side of Rose Arbour towards 9th St the evening of 9/13.

Redbud Trail - Access into the cul-de-sac will be restored for the weekend beginning end of day 9/11. Residents will need to park on the north side of Rose Arbour towards Chesapeake beginning the evening of 9/13 for mainline installation beginning 9/14.

Ashwood, Karabrooke, Countrywood - Top course of Asphalt is scheduled for 9/14.

Ramblewood, Maple Leaf, and Winddrift - Top course of asphalt is scheduled for 9/16.

Winddrift Ave - Concrete driveway repairs are scheduled for 9/14.

Bramble Dr & Rose Arbour (cul-de-sac) - Additional concrete repairs are scheduled for 9/14.

9/8/2026

Schedule Update

Rose Arbour (between Chesapeake and 9th St) - Mainline installation on this segment will now begin on 9/9. Residents in the Redbud Trail cul-de-sac and at 6499/6523/6545 Rose Arbour will need to park west of the intersection towards 9th St on the north side of Rose Arbour starting tonight. On 9/10 Redbud Trail residents should park east of the intersection towards Chesapeake/Bramble on the north side of the road.

Redbud Trail - Mainline installation is still anticipated to begin on 9/14.

9/4/2026

Rose Arbour(between Redbud Trail and Bramble Dr) - Road building will be delayed to next week due to the rain.

Ramblewood, Ashwood, Karabrooke, Countrywood, Winddrift, and Maple Leaf - Top course of asphalt has been rescheduled from 9/8 & 9/9 to 9/14 & 9/16.

Rose Arbour (between Redbud Trail and Bramble Dr) & Chesapeake Dr - Base course of asphalt is tentatively scheduled for 9/16.

9/3/2026

Bramble Dr & Rose Arbour (cul-de-sac)- Additional curb and gutter work is scheduled for 9/11. Restoration work will follow. Redline will place flags in yards as they complete grading for clearance to schedule any irrigation repairs.

Rose Arbour (between Redbud Trail and Bramble Dr) - Mainline sanitary installation is ongoing. Redline is working to rebuild as much of this segment as possible for access prior to the holiday weekend.

Chesapeake Dr - Mainline sanitary work will begin at the Rose Arbour and Chesapeake intersection starting 9/8 and end at the Winddrift Ave intersection. Residents will need to park on Winddrift Ave or open sections of Rose Arbour beginning the evening of 9/7.

Redbud Trail - Mainline sanitary work will start into this cul-de-sac beginning 9/14. Residents will need to park on Rose Arbour east of the Redbud Trail intersection beginning the evening of 9/13.

Rose Arbour (west of Redbud Trail to 9th St) - Mainline sanitary work on this segment will follow the completion of the Redbud Trail cul-de-sac. Pavement removals for this segment are scheduled for 9/14. Residents will maintain driveway access during this operation with some delays.

Ramblewood, Ashwood, Karabrooke, Countrywood, Winddrift, and Maple Leaf are scheduled for top course of asphalt on 9/8 and 9/9. Please plan for 30-45 minute delays during these activities. Remaining concrete driveways in this segment will now be repaired after top course of asphalt is placed.

9/1/2026

Directions for Paving Activities on 9/2/2026

Paving will begin in the Rose Arbour Cul-de-Sac and work towards Bramble Dr.

Bramble Dr. & Rose Arbour Cul-de-Sac

Residents whose driveways and/or approaches received concrete work must park on Rose Arbour between Chesapeake and Bramble Dr. beginning tonight or before work starts tomorrow morning. Please park on the north side of the road whenever possible.

Residents whose driveways and curb areas in front of their driveways were not affected by concrete work may continue using their driveways. Please allow for temporary access delays of 30 to 45 minutes during paving operations.

Residents at 6475, 6480, and 6442 Rose Arbour - Please park on the east side of Chesapeake beginning tonight.

8/31/26  Rose Arbour (cul-de-sac) has been added to the paving plans for this week. Redline is prepping the road base, fine grading the area and preparing for concrete replacement. Please plan for delays during this work.
8/28/26  Concrete work for Winddrift Ave, Maple Leaf Ave, and Bramble Dr has been pushed up to 8/31 and 9/1 and Bramble Dr base paving has been pushed up to 9/3.
8/28/26

Ramblewood Dr, Ashwood Ct, Karabrooke Ct, and Countrywood Ct - Top course of asphalt is scheduled for 9/8. Restoration work is ongoing. Please refer to the updated FAQ on restoration procedures for help with planning any irrigation repairs.

Winddrift Ave & Maple Leaf - Concrete driveway repairs are planned to start on 9/3. Top course of asphalt is also scheduled for 9/8. Restoration work is in progress.

Bramble Dr - Concrete repairs are scheduled to begin on 9/3. Base paving is now scheduled for 9/14.

Rose Arbour (cul-de-sac) - Mainline sanitary sewer is complete. Road restoration is in progress. Concrete repairs are tentatively scheduled to begin on 9/3 with other scheduled areas.

Rose Arbour (between Redbud Trail & Bramble Dr) - This is the next segment for mainline installation. Work will begin at the lift station and proceed to the east towards Bramble. This is expected to start 8/28 and continue the week of 8/31.

8/20/26

Ramblewood Dr, Ashwood Ct, Karabrooke Ct, and Countrywood Ct - Asphalt driveway repairs will continue through 8/21. Additional asphalt will be placed at the ends of concrete driveways for full access. Top course of asphalt is scheduled for 9/8. Restoration work is ongoing.

Winddrift Ave & Maple Leaf - Concrete driveway repairs are planned for 8/27 & 8/28. Top course of asphalt is also scheduled for 9/8.

H Ave - Reopen to regular traffic!

Bramble Dr - Mainline sanitary installation is still on track to be completed this week. Residents will have access to H Ave. Concrete repairs are scheduled for 8/27 & 8/28. Base paving is scheduled for 9/15.

Rose Arbour (cul-de-sac) - Sanitary mainline installation is still on track to begin the week of 8/24. Pavement removals for the remaining segment of Rose Arbour from Bramble to 9th St (including Redbud Trail, and Chesapeake Dr) have been rescheduled to 8/25.

8/14/2026

Ramblewood Dr - Concrete driveway replacement is in progress. We will continue to send updates on scheduling through next week. The top course of asphalt pavement for the road is tentatively scheduled for the first week of September. Asphalt driveways will be repaired at the same time as top course paving.

Winddrift Ave & Maple Leaf Ave - Base paving is scheduled for Wednesday 8/19.

H Ave - Paving is scheduled for Wednesday 8/19. H Ave will reopen to traffic after paving is complete.

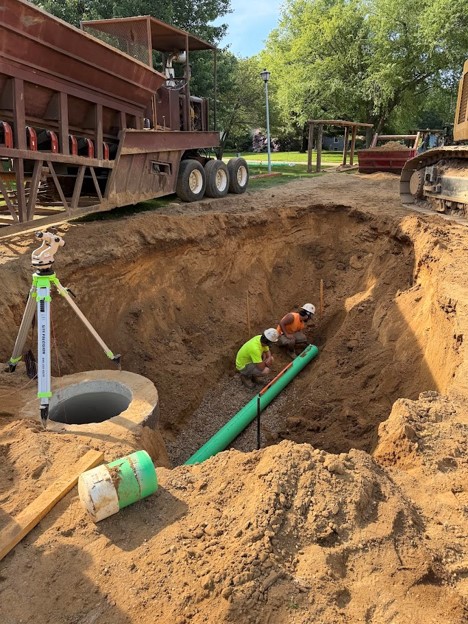

Bramble Dr - Mainline sanitary sewer installation, road rebuilding, and concrete curb and gutter replacement is expected to be completed by end of next week.

Rose Arbour - Sanitary mainline installation is expected to begin into the cul-de-sac the week of 8/24. Pavement removals on Rose Arbour from Bramble to approximately 50 feet west of Redbud Trail are now scheduled for 8/20.

Chesapeake & Redbud Trail - Pavement removal is scheduled for 8/20.

8/7/2026

Ramblewood Dr – Concrete work for driveways has been delayed 1 week. We now expect them to begin the week of 8/10. Crews will ensure residents have moved out of the driveway prior to pouring concrete. As a reminder, the concrete will need a minimum of 3 days to cure before residents will be able to use the driveway again. Residents will be able to park in front of the homes during this time.

Winddrift Ave – Mainline sanitary sewer is completed for the current section. Concrete curb and gutter replacement is expected to begin the week of 8/10.

Maple Leave Ave – Mainline sanitary sewer installation is completed for the east segment. Lift station work has begun near the Cutty Sark Dr intersection. The road will be partially closed in this area during this work.

Paving is scheduled for Winddrift Ave and Maple Leaf Ave the week of 8/17.

Restoration step 1 has started on Ramblewood and parts of Winddrift and Maple Leaf. The contractor has placed topsoil and initial seeding. Step 2 of restoration (hydroseeding and watering) will occur after the top course of pavement has been installed.

Bramble Dr – Mainline sanitary sewer installation will continue through the week of 8/10. The contractor has encountered unsuitable (clay) material that needs to be removed which has slowed progress. The H Ave closure will be extended through 8/19 to allow for removal of the unsuitable material from Bramble Dr.

Rose Arbour Ave (9th St to Bramble Dr) & Redbud Trail – Redline elected to wait for pavement removals of these areas to minimize disruption until closer to starting work on these streets.

7/30/2026

Ramblewood Dr - Concrete driveway work will begin the week of 8/3. They will be starting with driveways near H Ave and working to the south. Crews will ensure residents have moved out of the driveway prior to pouring concrete. As a reminder, the concrete will need a minimum of 3 days to cure before residents will be able to use the driveway again. Residents will be able to park in front of the homes during this time.

Winddrift Ave - Sanitary mainline installation is planned to be completed by 7/31. Redline will work through 8/7 on complete restoration of the road.

Maple Leaf Ave - access is planned to be restored by end of day 7/31.

Bramble Dr - Sanitary mainline installation is scheduled to begin on 8/10. H Ave will be closed completely starting 8/5 in preparation for this work.

7/29/2026  Bramble, Rose Arbour, and Redbud Trail pavement removals have been moved up one day to August 5th.
 7/28/26 Bramble, Rose Arbour, and Redbud Trail pavement removals are now scheduled for August 6th. This work is anticipated to take one day. Access will be delayed while Redline works to build ramps back up to driveways once milling is complete.
 7/23/2026

Ramblewood Dr - Driveway removals are underway. Gravel will be placed at the approaches for temporary access.

Driveways where the base course of asphalt has already been placed will be removed over the next week, with temporary gravel placed afterward.

Concrete driveways will be poured after the base course of asphalt is placed on the remaining segment of Ramblewood Dr and Countrywood Ct. Concrete driveways will be inaccessible for a minimum of 3 days while the concrete cures. Residents may park on the road during this time.

Asphalt drives will be paved when the top course of asphalt is placed throughout Ramblewood and all cul-de-sacs.

Base course paving for Ramblewood and Countrywood Ct is scheduled for Tuesday, July 28. Please expect delays during this work.

Winddrift/Maple Leaf - Sanitary mainline installation is complete up to the intersection of Winddrift and Maple Leaf.

The contractor will proceed south on Maple Leaf to approximately 6293 Maple Leaf. Crews will then return to Winddrift and continue west to approximately 6389 Winddrift.

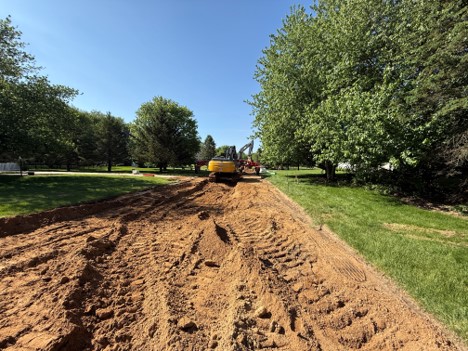

Road restoration on Winddrift is underway. Access from Ramblewood is expected to be partially restored by the end of the day on July 24. Please refer to the interactive map for current closure details.

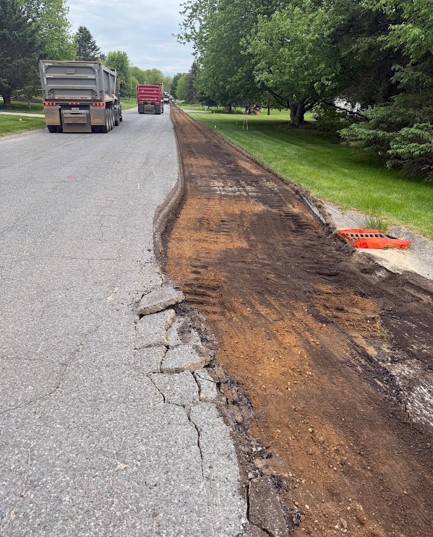

Bramble/Rose Arbour/Redbud - Pavement removals are tentatively scheduled for the week of July 27 in the following areas:

  • Bramble Dr, starting at H Ave and proceeding south
  • Rose Arbour, from the cul-de-sac to 9th St
  • Redbud Trail

Please expect delays during this work.

 7/17/2026 ***Update*** The Ramblewood Dr and Torrington Rd intersection will remain closed through this weekend. The contractor has encountered clay material and will need to remove it before rebuilding the road. Access to all driveways will be restored today and Ramblewood will remain open to H Ave.
 7/17/2026

Ramblewood Dr will be restored to gravel and fully open to Torrington Rd by end of day 7/17. Base paving of the remaining segment of Ramblewood Dr is expected to occur in early August.

Work will begin on Winddrift Ave the morning of 7/20. Residents at 2597 Ramblewood, 6208, 6209, 6232, and 6233 Winddrift will need to park vehicles on Ramblewood North of Winddrift or on Winddrift towards Maple Leaf the evening of 6/19.

 7/10/2026

Ramblewood Dr mainline sanitary sewer installation will be completed today. Redline will continue working on individual laterals and rebuilding the roadbed of Ramblewood Dr and Countrywood Ct to gravel base.  Driveway replacement work throughout Ramblewood and all adjacent cul-de-sacs is starting today with removals. Concrete driveway approaches will be replaced with concrete and asphalt approaches will be paved with the roadway. After new concrete is placed it will need to cure approximately 3 days before residents may drive over it. During this time residents may park in the road directly in front of their homes.

Pavement removals will begin Monday 7/13 on the east end of Winddrift Ave, from the Ramblewood Dr intersection up to 6364 Winddrift Ave and on eastern section of Maple Leaf Ave from Winddrift Ave intersection south to 6293 Maple Leaf/first curve. Mainline sanitary sewer installation will then immediate follow on Winddrift Ave starting at the Ramblewood intersection (expected Tuesday 7/14).

We cannot stress this enough, please remember to follow all safety guidelines in the construction area. Please do not allow children to play on or near any construction equipment or materials at any time. Do not stand within 30 feet of equipment (hazard zone) while work is occurring – this is an OSHA requirement.

 7/1/2026

The contractor will stop work early Thursday afternoon for the holiday weekend. From Thursday afternoon, Ramblewood will be open to residents from 2430 Ramblewood north, while residents at 2404 Ramblewood and south will need to enter and exit via Torrington.

Starting Sunday evening 7/5, residents at 2404, 2396, 2368, 2365, and 2336 Ramblewood should park on the west side of Ramblewood near or past Countrywood Ct.

 6/25/2026

Paving up to approximately 2552 Ramblewood Dr. including Karabrooke Ct will be completed by the end of the day. Please do not park on the new pavement overnight as it will need some additional time to cool. There may be bumps at driveway approaches after paving. Please enter/exit slowly. This will be temporary until we begin driveway replacement and other related work.

Mainline sanitary sewer installation will stop for this week near 2445 Ramblewood and focus will shift to installing laterals and re-building the road from 2552 Ramblewood to the South to restore access to as many residents as possible for the weekend.

The week of 6/29 will be a shorter holiday week. Redline will be working to restore as much of Ramblewood as possible to provide access through the holiday weekend.

We recognize that more sprinkler damage has occurred than anticipated. Many systems in this neighborhood were installed closer to the edge of pavement than we’ve seen on past projects, which has made avoiding damage more difficult. The Township and Redline Excavating will continue working to limit impacts while keeping the project moving as efficiently as possible.

We also understand residents are eager to repair damaged sprinklers and landscaping. However, we strongly advise waiting until after the top course of pavement is installed in the next two months. This will significantly reduce the risk of new damage from remaining construction activities.

Redline will be placing topsoil, grading, adjusting lateral riser heights, and seeding/hydroseeding up to and shortly after the top course of asphalt is paved. Top course of asphalt is intended to be later in the summer so we can do as much as possible at once and minimize the number of joints which become failure points in the pavement over the years. We appreciate your patience as we complete this work and restore yards once construction is finished.

Please review the safety guidelines at the link below. Our goal is to maintain a safe work zone for residents and members of the crews throughout the project.

Construction Site Safety Guidelines(PDF, 520KB)

 6/23/26

Ramblewood Dr will be restored to gravel up to 2552 Ramblewood by the end of the day on 6/23. Residents will have driveway access; however, expect minor delays through the end of the week as Redline prepares for additional paving, tentatively scheduled for 6/25 or 6/26.

Paving will include Karabrooke Ct and Ramblewood Dr up to 2552 Ramblewood Dr.

Residents at the following addresses—2489, 2475, 2442, 2469, 2457, and 2445 Ramblewood—must park on the south side of Ramblewood beginning the evening of 6/23.

 6/18/2026 Sanitary sewer mainline installation will stop near 2552 Ramblewood for this week and Redline will begin restoring access to residents on Ramblewood South of Winddrift. Mainline installation will resume to the South the week of 6/22/2026.
 6/15/2026

Construction on Ramblewood between Winddrift Ave and Countrywood Ct will progress slower than previous segments due to the depth of the sanitary main and the road layout. Residents may have extended periods of limited driveway access. Redline will work to restore access as quickly as possible.

Redline is planning to install a segment of sanitary sewer in Winddrift Ave from the Ramblewood intersection this week. This will allow the intersection to remain open when construction resumes down Winddrift Ave to the West later this season.

 6/12/2026

Construction is continuing South along Ramblewood from Winddrift. Starting Sunday evening 6/14 residents at 2573/2582 Ramblewood will need to park on the street South of their driveways on the East side of the road. Construction will extend to 2535/2538 Ramblewood by the end of the week. Access will be restored to driveways as soon as possible.

 6/5/2026

Base paving of Ramblewood from H Ave up to Karabrooke Ct, including Ashwood Dr is now complete. Restoration activities will take place in the coming weeks and final paving later this Summer.

Karabrooke Ct access is expected to be restored by end of day 6/5 and residents will be able to utilize Ramblewood to the North to enter/exit via H Ave.

Sewer main line work will continue next week on Ramblewood Dr to the Winddrift Ave intersection. Before continuing past Winddrift Ave, the contractor will pause mainline work and shift focus to installing laterals and restoring access to residents between Karabrooke Ct and Winddrift Ave.

Residents between Karabrooke Ct and Winddrift Ave may now park on the newly paved section of Ramblewood, or on Winddrift through the weekend.

 5/28/26

Ashwood Dr is expected to be reopened on 5/29. More unsuitable soils must be removed than anticipated and that has slowed road building.

Ramblewood Dr is expected to be restored up to Karabrooke Ct by end of day 5/29.

Work on Karabrooke Ct will begin Monday, 6/1. Residents should park on Winddrift until access is restored. Work is expected to take 3-4 days depending on soil conditions.

A new segment of pavement will be removed from Ramblewood starting on 6/2. There will still be access after the pavement is removed. Expect some delays during this activity.

Ramblewood and Ashwood Dr are tentatively scheduled for base paving on 6/4. There will be intermittent disruptions to access during this activity.

 5/27/2026 There is currently an isolated outage with Metronet fiber internet. There have been issues with the accuracy of the marking for communication lines. Redline is working with the MissDig contractor to resolve the issues and limit further disruptions. Service will be restored as soon as possible.
 5/22/2026

Construction activities will be stopping for the week around 3 pm on Friday 5/22 in preparation for the holiday weekend. No work will be performed on Memorial Day.

H Ave will be reopened the afternoon of Friday 5/22. Ramblewood Dr North of Ashwood Dr will have limited access restored for residents for the Holiday weekend.

Work in the Ashwood Dr cul-de-sac will begin on Tuesday 5/26. Residents should plan to park their vehicles on Ramblewood Dr South of Ashwood Dr the evening of Monday 5/25. Access directly to driveways will be restored as soon as possible.

5/19/26

Redline has begun sanitary sewer install in Ramblewood Dr. Crews expect to reach the intersection of Ashwood Dr by end of day 5/20. Residents on Ramblewood will need to park South of construction while Ramblewood is rebuilt. Limited access from H Ave to driveways will be restored as soon as possible.

Residents may have received a wooden stake painted green at their front door. This is to mark the connection point for your home. If you need assistance, please contact Public Works or the onsite inspector from Fleis & Vandenbrink.

5/14/26

Redline Excavating will begin pavement removals on Ramblewood Dr starting at H Ave and working South on Friday, 5/15. Residents will retain access to their driveways during this work.

Sanitary sewer installation work is planned to begin on Monday, 5/18. The intersection of H Ave and Ramblewood Dr will be closed during this process and detours will be posted.

5/12/26 Redline Excavating has begun clearing on a Township parcel located at the end of Bluffton Ave. This area will be utilized for construction staging during the phase 2 project.
4/30/26 Informational meetings for Contract D (Westport North) are scheduled for May 9th from 11 am - 1 pm and May 13th from 4 pm - 6 pm. Post card invitations for these meetings are being mailed to each resident. Each meeting will feature a presentation on the construction schedule and impacts. There will be an opportunity for questions and answers after the presentation.
4/27/2026 The Township intends to award Contract D (Westport North) and E (Westport South) at the April 28th Township Board Meeting. Construction on Contract D is planned to begin this year, with Contract E planned for 2027. Invitations to informational meetings for residents in Contract D will be going out this week.
4/13/2026

Phase 2 bids were opened on April 1st. The Township received 1 bid for contract D, which is the North portion of Westport from Wyndham Dr and Torrington Rd North to H Ave. The contractor is Redline Excavating, who also completed Phase 1. The contract will now be conditionally awarded at the April 28th Township Board meeting and public meetings will be scheduled for May, with construction beginning in late May/early June.

The Township is working through a competitive re-bidding process for Contract C (Country Club Village) and Contract E (Westport South). Additional information will be available once re-bidding is completed.

3/24/2026 Consumers Energy plans to replace older gas service lines in the Phase 2 neighborhoods of Westport and Country Club Village. This work is separate from the sanitary sewer expansion projects and is expected to be completed beforehand. The Township is coordinating closely with Consumers Energy on these infrastructure upgrades to minimize disruptions for residents.
3/4/2026 Phase 2 projects are going to be advertised for bids starting on March 6th. Bids will be received through March 31st and opened at Township Hall on April 1st. The contracts are scheduled to be awarded at the April 14th Township Board meeting and neighborhood meetings will be scheduled shortly after. Postcards will be sent to all properties in the project areas with details on the neighborhood meetings.



Neighborhoods / Streets

Phase 2 has been updated to Westport North and South. Contract C will now be part of a future phase 3 project.

Map of Westport: Contracts D & E (PDF, 1MB)

Contract D - Westport North

  • Ramblewood Dr
  • Windrift Ave
  • Maple Leaf Ave
  • Torrington Rd
  • Bramble Dr
  • Rose Arbour Ave
  • Chesapeake Dr
  • Cutty Sark Dr
  • Nightingale Ave
  • Signal Hill Dr
  • Wyndham Dr
  • Wild Cherry Ln
  • Walker Trail
  • Saybrook Dr
  • Countrywood Court
  • Karabrook Court
  • Ashwood Court
  • Chippendale Dr
  • Morningstar Way
  • Redbud Trail





Contract E - Westport South

  • Old Log Trail
  • Wild Cherry Ln
  • Killington Dr
  • Twilingate St
  • Wingate Rd
  • Thunder Bluff Rd
  • Litchfield Ln
  • Breezy Point Ln
  • Breckenridge Dr
  • Old Deer Run
  • Shugarbush Trail
  • Nantucket Ln
  • Rudgate Dr
  • Bunkerhill Dr
  • Valley Forge Rd
  • Cadet Ln
  • Trundel Ln
  • Brogan Hill
  • Sanfield Ln
  • Bluffton Ave





Construction Site Safety




Construction Schedule

Construction is planned for Westport North in 2026 and 2027. Westport South will begin in 2027 and finish in 2028.

Please refer to the construction FAQ for timing of driveway repairs.

  • 2026 Construction will begin at Ramblewood Dr and H Ave the week of May 18th.
  • Ramblewood Dr is anticipated to be completed by the end of July.
  • Winddrift/Maple Leaf will begin in late July.
  • Bramble/Rose Arbour in August.
  • Rose Arbour/Chesapeake/Redbud will be the final segments for the 2026 season and will wrap up in October.

Frequently Asked Questions - Construction

This FAQ will be updated throughout the project. If you have a question that is not listed below, please contact Public Works by phone at 269-216-5244 or email - publicworks@oshtemo.org

FAQ: How will my driveway be repaired if there is damage from construction?

Answer:

  • Concrete damaged from project equipment or operations will be sawcut and removed. Public Works Staff and field crews will assess the exact limits/location to ensure integrity for remaining driveway and minimize long term deterioration.
  • Temporary gravel or like material will be placed to maintain access. Depending on the duration and weather, this may need to be regraded or more material added. On average residents should expect a 2”-3” bump/drop.
  • 1-2 days before concrete work is scheduled crews will remove the temporary gravel and prep the approach. A small ramp will be installed to maintain access. Residents may also park in the street.
  • Staff will send out text messages to those who signed up or attempt one in-person visit to notify residents of planned date for concrete at least 24 hours in advance to get vehicles relocated from driveways to street in front of their property for parking.
  • Driveways will be graded, formed and poured on the same day. The concrete will be sprayed with a sealant type of material which may look like white watery paint.
  • The new concrete will need to cure (aka “dry”) for 72 hours beginning the day following the initial pour. Crews will place caution tape at the end of the driveway to block access. Residents may remove the caution tape and begin using the new concrete after 72 hours have passed.
    • For example: driveway is poured on 8/11, the 72-hour window begins on 8/12. Driveway may be used again on 8/15.
  • Driving on or using concrete, including but not limited to bicycles, lawnmowers, pets, etc. before the end of the minimum curing period may result in damage. The contractor will not be responsible for additional repairs.
  • Asphalt driveways will be repaved between base and top courses of apshalt. These can typically be used again the same day of paving.

FAQ: Are mailboxes being relocated?

Answer: Mailboxes may be temporarily relocated during construction but will remain on your property. The contractor will typically replace the mailbox post during reinstallation.
There may be temporary disruptions to mail delivery. USPS has the option to place a hold for mail pickup at the nearest post office.

FAQ: What will happen to my trash and recycling services?

Answer: Continue to place your trash and recycling at the end of your driveway as usual. If your regular provider cannot access your property, the contractor will collect trash. There may be delays in pickup, so please leave containers at the road until they are emptied.

FAQ: How will emergency services respond to my property if I need them?

Answer: Public Works coordinates with EMS daily during the project to ensure access plans are in place for properties directly affected by construction.

FAQ: How is my connection point determined?

Answer: Prior to construction in front of your property, the resident project representative will provide a wooden stake for you to mark the location. The inspector or Public Works can assist with marking the location.

FAQ: How will bus stops be affected by construction?

Answer: Public Works shares the project schedule and timeline with the Kalamazoo Public Schools Transportation Department. KPS will adjust bus stops as needed and will notify parents directly of any changes.

FAQ: Will my yard be restored?

What residents can expect during yard restoration.(PDF, 521KB)

As paving and related work progress, the Township and its contractor will restore disturbed yard areas. Because timing varies by location and property type, follow the steps below to learn when lawn care and irrigation repairs may safely resume.

Homes Without Curb and Gutter

  • After the first asphalt layer, the contractor will grade disturbed areas and place initial topsoil. Final restoration will generally include 4 to 6 inches of topsoil.
  • Hand seeding may be used for initial soil stabilization.
  • Residents may repair irrigation systems after this initial work, but components within the public right-of-way remain at the owner’s risk while construction continues.
  • After final paving, crews will rake, treat weeds, and add topsoil as needed. To opt out of weed treatment, email publicworks@oshtemo.org before final restoration begins.

Homes With Curb and Gutter

  • After curb and gutter replacement, the contractor will grade disturbed areas and place topsoil.
  • Wait for a flag in your yard before scheduling or beginning irrigation repairs.

Final Restoration for All Homes

  • Crews will hydroseed disturbed areas and water twice weekly until the grass is healthy, established, and free of erosion, weeds, and disease.
  • Residents will be notified when regular watering, mowing, and lawn care become the property owner’s responsibility.

Important Irrigation Reminder

Follow the timing for your property before repairing irrigation. Private irrigation lines, sprinkler heads, and other improvements in the public right-of-way remain the owner’s responsibility and may be affected by continuing construction.

Questions? Contact the Township Public Works Department at publicworks@oshtemo.org.



Construction Glossary

Did you see something on a construction site and want to know more? Did you talk to someone or overhear a conversation in the field and want to learn more? Check out some of the common terms used:



  Term Definition

Survey Stake Translates engineering design plans into real-world coordinates and directions, giving crews dimensions, reference points, and elevation guidance. Typically marked with pink ribbons and writing.
   Soil Erosion and Sedimentation Control (SESC) Tools and methods used to prevent and capture disturbed soil such as topsoil and silt, protecting storm systems and downstream water quality.

Silt Sacks Temporary, reusable filters for storm water inlets that capture rocks, topsoil, silt, and debris.

Utility Flags/Markings Colored flags and spray-painted lines marking underground infrastructure to prevent damage during excavation. Common colors: yellow (gas), red (electric), green (sewer), blue (water), orange (communications).

Milling Process of removing asphalt by grinding it into small pieces for efficient removal and reuse.
  Hot Mix Asphalt (HMA) Pavement material made of ~95% aggregates and 5% asphalt cement binder. Used as the top driving surface, typically installed in multiple layers.

Sand Subbase Bottom road layer providing drainage and foundational support; not suitable for regular vehicle travel.

Gravel Base Middle road layer between sand and asphalt providing structural support and drainage; can serve as a temporary driving surface.

Riser (Cleanout) Vertical pipe providing access to underground sewer lines for maintenance. Temporarily extends above ground before being cut down below grade.

Wye A pipe fitting used to branch or connect lines securely.
  Right-of-Way Land reserved for public roads and utilities, typically about 66 feet wide in residential plats.

Unsuitable Soils Soils lacking strength, stability, or drainage to support infrastructure, often requiring testing before reuse.

Roller Heavy equipment used to compact soil, gravel, or asphalt by reducing air pockets and creating a smooth, durable surface.

Trench Box Steel protective structure used in excavations to prevent trench collapse and protect workers.

Excavation The controlled digging or removal of earth for installing or repairing underground infrastructure.

Resident Project Representative (RPR) On-site professional representing the owner, ensuring construction follows plans and specifications (does not direct construction methods).
  Compaction Process of compressing materials to increase density and stability.

Manhole (Structures) Access point large enough for workers to enter underground systems for inspection and maintenance.

Catch Basin / Inlet Structure that collects surface runoff and directs it into the storm sewer system.
  Illegal Tap An unauthorized connection to a utility line, such as improper sump pump discharge into storm sewers.

Restoration Repair or replacement of disturbed areas including grading, topsoil, seeding, and protective coverings.

Connection Process







There are two main steps each property owner must take to get connected to sanitary sewer once they have received the notice to connect.

  1. Pay Public Connection Fee: The total fee is $7,500 per residential property and is due before your contractor begins the physical connection. This fee can be financed with the Township through an installment payment agreement. More information on this agreement can be found in the resources section.
  2. Hire Contractor for Private Connection: Be sure top get multiple quotes as prices and methods may vary. The township recommends getting multiple quotes for your connection. A few common connection methods are directional boring, open trenching, and rerouting interior plumbing. Costs are typically between $5,000 and $7,000. Financial help is available through USDA programs offering grants and low-interest loans, as well as township hardship financing and deferment options. Additional information on these options can be found in the resources section.

Resources

Public Connection Fees can be financed through an installment payment agreement. There is a $500 down payment required and the remaining balance is financed over a 20- or 40-year term. For more information on installment payment agreements please contact Public Works or complete the form below to request an agreement for your property.

For details and information on the assistance programs available for the Private Connection Fees please visit-



Once connected to sanitary sewer, the existing septic system will need to be properly abandoned.



FAQ: What will this project cost me?

Answer: Connection costs have several components.

Public Connection Fee: $7,500 from the sewer main in the road to the right-of-way/property line

  • Benefit Fee: $2,000 for a single-family home (1 benefit unit) *commercial properties will have more benefit units.
  • Parcel Fee: $5,500 per parcel (same amount for all parcels, regardless of size or use).

Private Connection Fee: $5,000 to $7,000 from the right-of-way/property line to where the sewer exits the home.

  • Contact local excavating contractors for a quote.
  • Costs vary based on:
  • Distance from the home to the road.
  • Patios, decks, pools, fences, sheds, or other obstacles.
  • Tree removal (ask your contractor if trees can be avoided).
  • Location of existing interior plumbing.

FAQ: What are my payment options for the public connection fee?

Answer: You may pay the connection fee in full or enter a 40-year Installment Payment Agreement (IPA).

  • A $500 down payment is required.
  • The remaining $7,000 is financed at 3.375% interest.
  • Annual installments are paid with your winter tax bill.
  • There is no penalty for early payoff.

FAQ: When do I have to connect?

Answer: You will receive a notice once construction in front of your home is complete, including paving and testing. From the date on that notice, you will have two years to connect.

FAQ: How do I get connected?

Answer: Each property owner is responsible for hiring a contractor to connect the home to the new sanitary sewer. The Township website includes a list of contractors familiar with this work.

FAQ: Can I finance the private connection costs?

Answer: Most contractors do not offer financing, however:

  • Assistance programs may be available through the U.S. Department of Agriculture (USDA).
  • The Township offers a Hardship Assistance Program.

Contractor Information

Redline Excavating is a Michigan based contractor from Holland, MI.

The Consulting engineer is Fleis & Vandenbrink, an employee owned company.

List of contractors for the private connection(PDF, 189KB)
